FACULTY: Arts, Computing, Engineering and Sciences
DEPARTMENT: Engineering and Mathematics MODULE TITLE: Project and Quality Management
MODULE LEADER: Dong Zhang
TIME ALLOWED: 2 hours (plus 10
minutes reading time)
EXAMINATION CONDUCT:
1.
The Examination Conduct Policy outlines the
behavioural expectations of candidates attending any examination.
2.
It is a fundamental principle that students are
assessed fairly and equitably. The University Academic Conduct Regulation
defines unfair behaviour relating to an examination to be 'cheating'. The
University will investigate and may sanction any acts or behaviours which
breach the Code of Academic Conduct.
INSTRUCTIONS TO CANDIDATES:
1.
Please do NOT
start writing until told to do so by the
invigilator.
2.
Candidates must NOT
use red ink on the script answer book.
3.
Candidates will bring their own advanced
calculator or standard calculator. Calculators must display either an approved
advanced calculator sticker (blue) or an
approved standard calculator sticker (red).
4.
Answer question 1 in Section A and two
questions from Section B (THREE in total). No mark will be awarded for
attempting further questions.
5.
This is a CLOSED BOOK exam. NO material
may be taken into the exam.
6.
This examination paper MAY be taken from the venue by the candidates.
7.
For question 1 show the full working
process for all calculations.
STATIONERY REQUIREMENTS PER CANDIDATE:
·
1 x 16 Page Answer Booklet(s)
THIS PAPER
CONTAINS 4 PAGES INCLUDING THIS SHEET Page 1 of 4
Section A
1.
Consider a project with the information in Table 1.

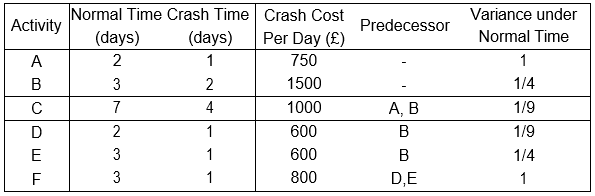

Table 1
The project is
budgeted with a fixed daily labour cost of £500 per day. There is no materials
cost. For each activity there is an overhead of £500.
a).
Construct the project network diagram using
Activity-on- Node methodology, showing ESTs, LSTs, and total floats for each of
the activity under normal time. Identify the project duration and the critical
path under normal time.
(9 marks)
b).
Develop a full crashing schedule table for the
project. Clearly show the action, the
step cost, and the critical path after each
crash.
(12 marks)
c).
Identify the overall project cost when the project
is fully crashed.
(4 marks)
d).
A performance review 2 days after the project
started finds that activity A has been completed on time; activity B has also
been completed, ahead of schedule; activities C, D and E are about to start. Calculate the probability that
activity C being completed within the normal project duration.
*See next
page for the z-table.
(5 marks)
e).
Based on the progress found in the performance review, calculate the Schedule
Performance Index using the percentage rule.
(6 marks)
f).
It is estimated that all activities in the project
will benefit from a learning rate of 0.894427. Using the normal time in Table 1 as the starting point, calculate at
which repetition the normal time of the project will be reduced by 2 days.
(4 marks)
Total
(40 marks)
Z-table showing the areas under the standardised
normal curve for z ≥
0
Section B (answer two questions in this section)
1.
Critically evaluate the importance for organisations
to develop coherence in managing and delivering projects.
(30
marks)
2.
Discuss whether it is possible or not to eliminate
risks through careful project planning.
(30
marks)
3.
Discuss why it is difficult to implement a perfect
project control system.
(30
marks)
4.
Evaluate the role of project review in the process
of continuous improvement for organisations.
(30
marks)
END
